Insulation Resistance vs Power-Frequency Withstand Tests for Medium-Voltage Switchgear

An insulation resistance test applies controlled DC voltage and reports resistance; a power-frequency withstand test applies specified AC stress and records whether the switchgear withstands it without disruptive discharge. The first is a diagnostic or screening measurement. The second is a proof test. They are complementary, not interchangeable. A high megohm reading cannot prove AC withstand capability, and a passed AC withstand test does not create a useful condition baseline. For any medium-voltage switchgear cabinet, the approved procedure must define the test voltage, connection, exclusions, environment, acceptance source, and release authority.

Know What Each Test Proves

Use the comparison as a release matrix, not as permission to select test settings. IEC 62271-200:2021 covers AC metal-enclosed switchgear above 1 kV and up to and including 52 kV, but the applicable project specification, manufacturer instructions, and approved test procedure still govern the test applied to a particular assembly.

Review point Insulation resistance Power-frequency withstand Release implication
Question answered Is DC leakage through the measured insulation path consistent with the approved criterion or baseline? Can the configured test object sustain the prescribed AC stress? Neither result replaces the other
Source Controlled DC from an insulation-resistance tester Controlled power-frequency AC from a suitable test set The source and waveform must match the procedure
Output Resistance plus elapsed time and test conditions Withstand result plus observations and protection response A bare value or a bare pass is incomplete evidence
Typical role Screening, baseline, comparison, and condition review Factory, site, or post-repair proof testing where specified Factory and site requirements may differ
Acceptance source Approved criterion, comparable baseline, phase/path comparison Specified voltage, duration, configuration, and pass/fail rule Do not invent a universal threshold
Common misuse Reading megohms without configuration, temperature, or exclusions Reusing a factory level as an automatic site retest level Place the test on hold until the basis is confirmed

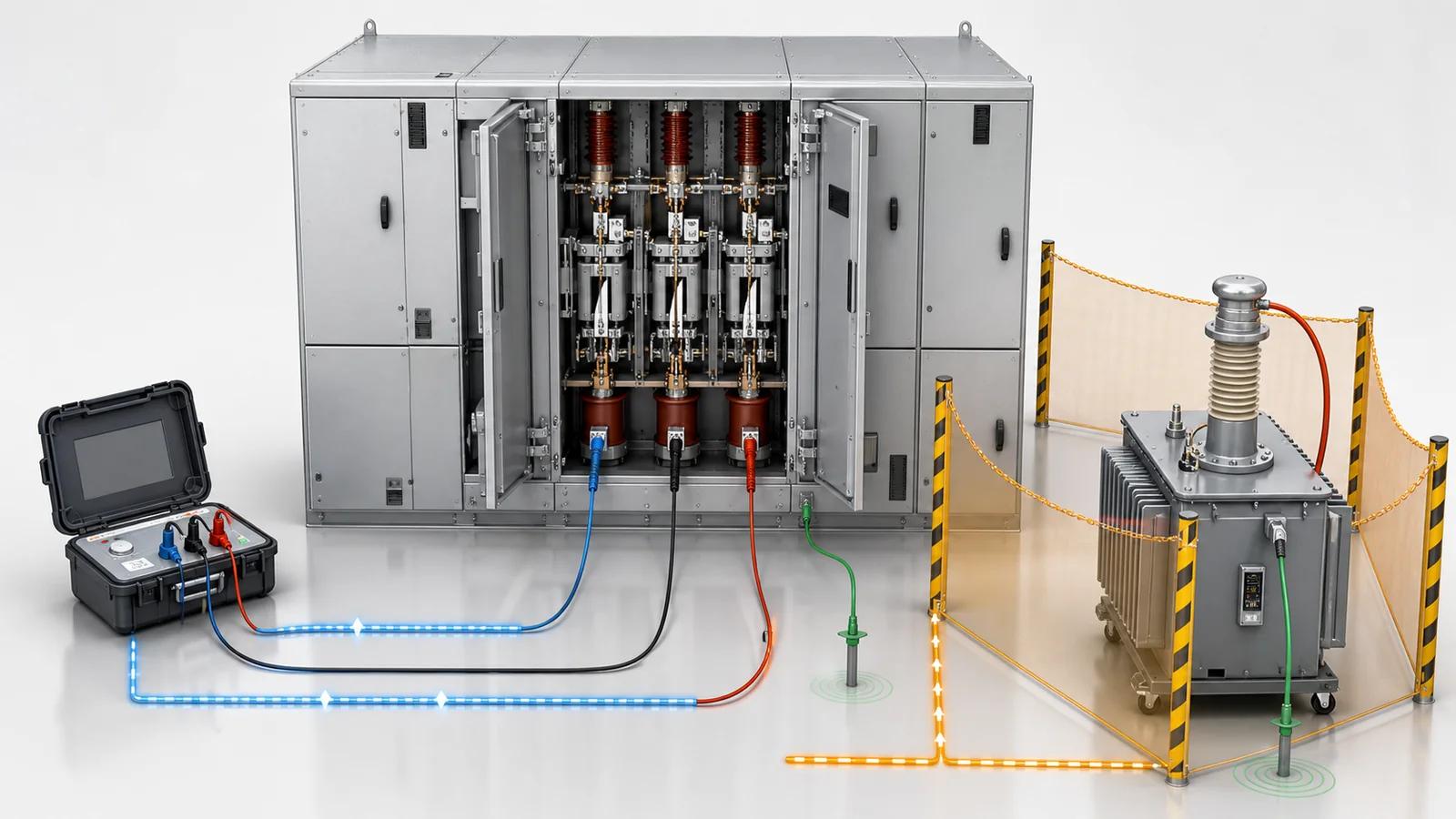

Visual comparison of DC insulation resistance measurement and AC power-frequency withstand testing
IR is a diagnostic resistance measurement; power-frequency withstand is an AC proof test.

The terminology matters. Insulation resistance is not main-circuit or contact resistance, which measures the closed current path and joints at much lower resistance. Power-frequency withstand is also not DC hipot, VLF, partial-discharge, or tan-delta testing. Those methods answer other insulation questions.

A quick diagnosis table helps reviewers stop an invalid record before it reaches the release pack:

Symptom First test or check Likely cause to investigate Next action
IR phases differ materially Confirm test connection, environment, and exclusions Moisture, contamination, connected device, lead routing, or insulation condition Inspect, correct the boundary, and repeat only under the approved procedure
IR sheet has values but no conditions Compare the sheet with the test diagram and instrument record Incomplete evidence rather than proven insulation failure Hold interpretation and recover or repeat the record
AC test trips or produces abnormal sound Make the system safe and preserve event data Test-set issue, incorrect connection, surface discharge, or dielectric defect Raise a nonconformance; investigate before any retest
AC sheet says only pass Check voltage, duration, configuration, and observations Missing traceability Request the complete test record before technical release

Release the Assembly Before Connecting a Test Set

The responsible test authority owns the switching, grounding, connection, and safety sequence. An article cannot replace the site safety plan or equipment-specific procedure. The release check should nevertheless expose every boundary that can invalidate the result or expose connected equipment to the wrong stress.

  • Confirm de-energization, absence of voltage, lockout/tagout, and stored-energy discharge.
  • Mark the tested bus sections, breaker poles, cables, and compartments on an approved diagram.
  • Record earth-switch, breaker, and disconnector positions for each configuration.
  • Separate cables where the approved procedure excludes them from the cabinet test.
  • Isolate or remove voltage transformers, surge arresters, control-power transformers, sensors, electronics, and auxiliary circuits where required.
  • Verify temporary leads, guard connections, clearances, grounding, test-set protection, emergency stop, barricades, and the exclusion zone.
  • Authorize any defeated interlock, record it, and include restoration in the close-out checklist.
  • Prepare the return-to-service check before voltage is applied, not after the test team starts removing leads.

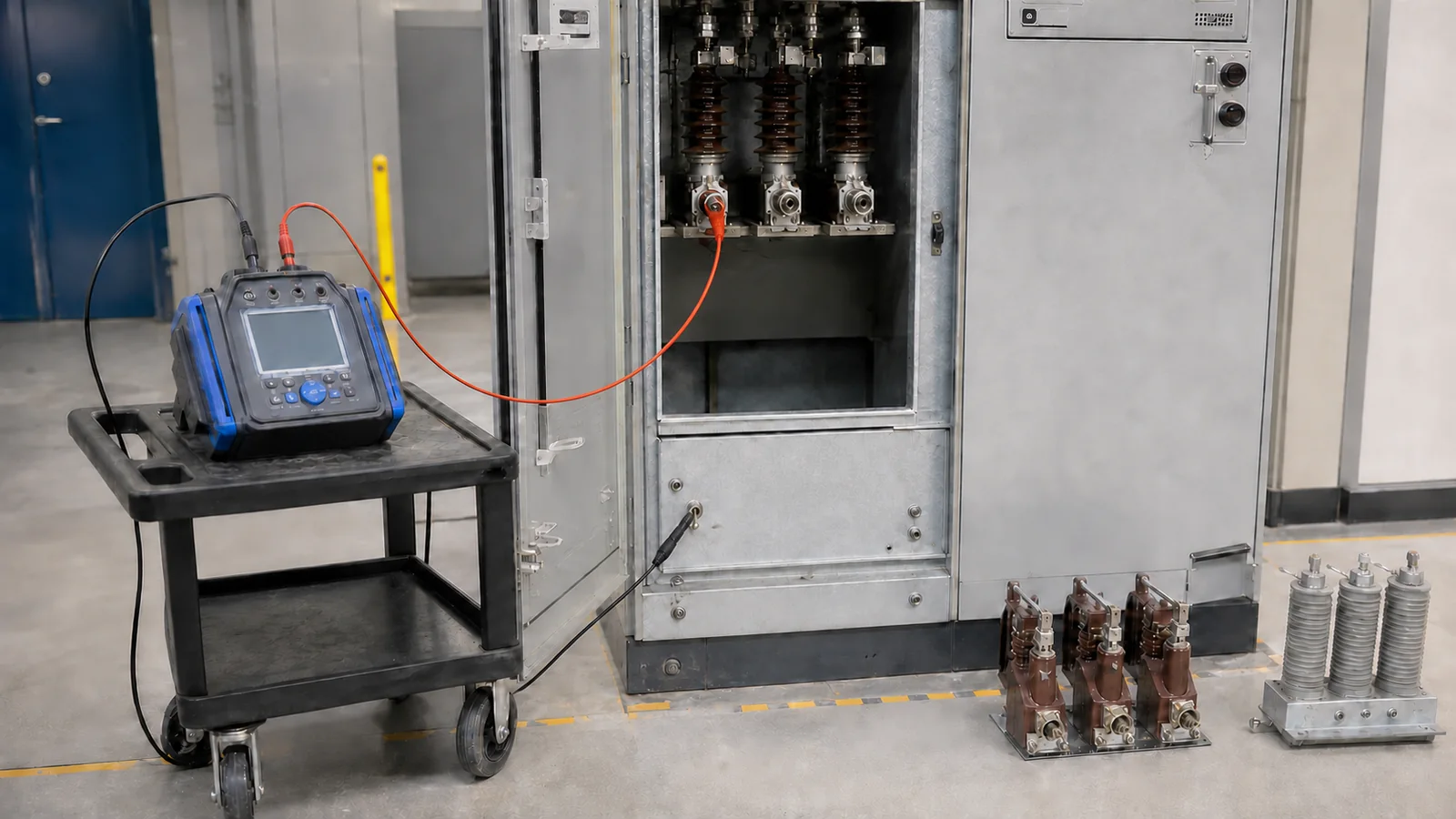

Safe insulation resistance test boundary on isolated medium-voltage switchgear
An interpretable IR record starts with the correct isolation, connection, environmental data, and discharge controls.

The cabinet rating provides context, not an automatic test setting. A reviewer who needs that context should first confirm the distinctions in how to read medium-voltage switchgear ratings. The test value and sequence must then come from the governing documents for the actual assembly and test stage.

Make an Insulation-Resistance Record Interpretable

When DC voltage is applied, charging and absorption currents decay before the remaining leakage current becomes dominant. That is why elapsed time and prior discharge matter. Surface moisture, contamination, temperature, connected devices, test-lead routing, and guarding can change the measured path even when the bulk insulation has not changed.

Record field Why it matters Review action when missing
Test voltage and elapsed time Results from different settings or times are not directly comparable Hold trend comparison
Phase-to-earth or phase-to-phase connection Combined paths can hide a local issue Request the as-tested diagram
Included and excluded equipment Arresters, transformers, cables, and electronics change the path Reconstruct the boundary or repeat the test
Temperature and humidity Both affect surface and bulk leakage Mark the result as condition-incomplete
Surface condition and guarding Dust, moisture films, and surface leakage can dominate Inspect, clean if authorized, and document guard use
Instrument and calibration status Establishes traceability Confirm model, serial number, and valid calibration reference
Result and discharge confirmation Links the measured value to a safe close-out Record each path and the completed discharge/grounding step
Baseline or acceptance source Turns a number into a controlled decision Identify the approved criterion or comparable maintenance record

There is no universal acceptable megohm value for every MV lineup. Interpretation depends on insulation system, rated voltage, applied DC voltage, elapsed time, conditions, configuration, and the agreed criterion. Phase comparison and trend analysis are useful only when those variables are comparable. A low or uneven reading is a diagnostic signal; it is not automatically proof of a failed AC insulation system. A high reading is similarly bounded: it does not authorize the next proof test.

Control the Power-Frequency Withstand Test as a Proof Test

The AC test applies substantially different electrical stress. Its voltage, duration, connection, and any reduced site or retest level must be approved for the equipment and test stage. Do not copy a product manual’s value into another lineup or infer it from the basic switchgear rating definitions.

Test phase Required control Evidence retained
Pre-test release Verify diagram, exclusions, grounds, clearances, personnel, and test-set protection Signed checklist and approved revision
Controlled ramp Raise voltage from zero according to the procedure Start time and ramp record
Prescribed hold Observe current, protection, sound, and visible activity Hold timing and observation log
Abnormal response Stop, ramp down, de-energize, discharge, ground, and preserve evidence Event record and nonconformance
Controlled ramp-down Return voltage to zero before source isolation End time and operator confirmation
Discharge and restoration Ground the test object, remove leads, reconnect exclusions, and restore interlocks Signed restoration checklist
Retest Use only an approved scope, level, and authorization Corrective action and retest approval

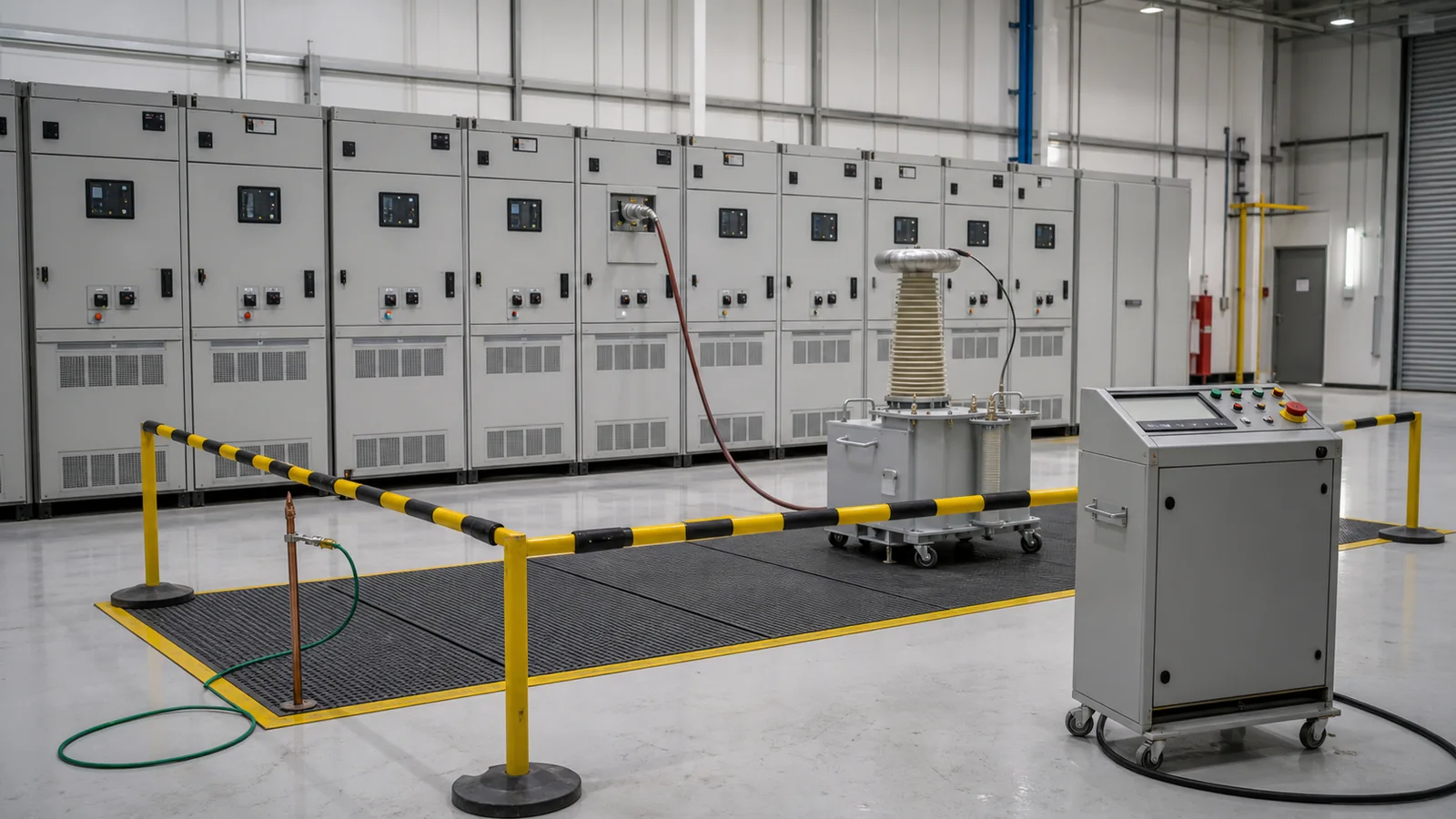

Controlled power-frequency withstand test setup for medium-voltage switchgear
AC withstand testing needs an approved ramp, hold, observation, ramp-down, grounding, and restoration sequence.

A favorable IR record does not remove any of these controls. It says only that DC leakage was acceptable under the recorded configuration and conditions. It cannot show that every connected component is suitable for AC test stress or that the assembly will withstand the prescribed proof-test condition.

This test may appear within a wider switchgear factory acceptance test, but CAB-10 owns only the electrical test distinction. Mechanical operations, wiring checks, protection tests, inspection points, deviations, and shipment release still belong to the full FAT plan.

Interpret Results Without Overclaiming

The result should support a bounded decision, not a broad claim about service life or every insulation defect.

Observed record What it supports What it does not prove Next controlled action
Complete, comparable IR record DC leakage path is consistent with its approved criterion AC withstand or absence of every latent defect Retain as baseline; proceed only if the next test is separately released
Low or uneven IR with moisture or contamination A path needs inspection Root cause or permanent insulation failure Inspect, clean or dry as authorized, then repeat under comparable conditions
IR configuration or environment unknown A measurement occurred Interpretability or comparison Hold; recover evidence or repeat the measurement
AC test completed with no disruptive discharge under the approved condition The configured object withstood that prescribed test Long-term life, partial-discharge state, or performance under a different condition Complete restoration and file the evidence
Trip, abnormal current, sound, or visible discharge An abnormal test event occurred Exact location or cause Make safe, investigate, and raise a nonconformance
Cleaning or repair followed by proposed retest Corrective action was attempted Closure of the original cause Obtain approved retest scope and authorization

Representative diagnostic example, not a XIYA project or commissioning record. A 12 kV metal-enclosed lineup has phase-to-earth and phase-to-phase IR entries, but the sheet omits temperature, humidity, connection diagrams, and confirmation that voltage transformers, surge arresters, or control-power transformers were isolated as required. No measured field values or pass result are claimed here.

The correct decision is to hold interpretation and release. Reconstruct the test boundary, check the instrument and calibration record, inspect the relevant surfaces, and repeat only under an approved procedure if the missing evidence cannot be recovered. Any required AC withstand test starts only after its own preconditions are accepted. This preserves useful engineering detail without turning an illustrative record review into fabricated first-hand experience.

Build a Test Evidence and Release Package

The release package must connect the test result to the exact lineup, configuration, procedure, tools, and acceptance source. A practical data pack includes:

Deliverable Minimum evidence
Governing basis Approved procedure, standard hierarchy, purchaser project specification, and acceptance criteria
Equipment identity Lineup, panel designations, serial identifiers, and current drawing revision
Test boundary As-tested diagram, connections, included equipment, and signed exclusion list
Conditions Temperature, humidity, surface condition, and test time
Tools Insulation tester or AC test set identity, serial number, settings, and calibration status
Execution record IR elapsed time and paths, or AC ramp/hold/ramp-down data and observations
Result Raw readings or withstand decision for every required configuration
Exceptions Protection response, deviations, nonconformance, corrective action, and retest authorization
Restoration Discharge, grounding, reconnection, interlock restoration, and return-to-service checks
Release Test engineer, witness where required, approval authority, date, and hold/conditional/released status
Switchgear insulation test evidence package with configuration, instrument, result, and release records
The evidence pack connects each result to the lineup, procedure, environment, test set, deviations, and release authority.

The complete evidence pack is more valuable than an isolated certificate line because it lets another reviewer reproduce the decision basis. To align a cabinet configuration with an approved test boundary, send the switchgear specification, single-line diagram, test requirements, and record template through XIYA POWER’s technical inquiry channel. The review should confirm configuration and evidence requirements; it should not promise acceptance of an unverified result.

Frequently Asked Questions

What is the difference between insulation resistance and power-frequency withstand testing?

IR applies controlled DC and reports resistance under recorded conditions. Power-frequency withstand applies prescribed AC stress and records whether the configured test object withstands it. One is diagnostic; the other is a proof test.

Can a megohmmeter test replace an AC withstand test?

No. Low DC leakage does not prove performance under AC proof-test stress. Where both are required, each needs its own approved connection, settings, observations, and acceptance decision.

What equipment may need to be disconnected before switchgear insulation testing?

Depending on the procedure, the list may include surge arresters, voltage transformers, control-power transformers, cables, sensors, electronics, and auxiliary circuits. The test authority must confirm and record the exact exclusions.

What is an acceptable insulation-resistance value for medium-voltage switchgear?

There is no single value for every lineup. Use the approved acceptance criterion and interpret the result with the test voltage, elapsed time, insulation system, environment, connection, exclusions, and comparable baseline.

Why can a site withstand test differ from a factory test?

Installation, connected equipment, environmental conditions, prior service, and the governing field-test rules differ from factory conditions. The applicable standard, project specification, OEM instructions, and approved site procedure determine the field level and sequence.

What records should a buyer request for switchgear insulation tests?

Request the procedure, equipment identity, as-tested diagram, exclusion list, environmental record, instrument and calibration details, settings, raw results, observations, deviations, corrective actions, retest authorization, restoration checklist, and signed release status.
